We’re excited to keep you informed on the progress of our new Cantiro townhomes in Arbour Lake West! This dedicated space is designed to access monthly updates, construction milestones, and important information about your future home in the vibrant Arbour Lake West community. Stay connected with us as we work diligently to bring your dream home to life. Thank you for being a part of this journey with Cantiro Homes!

  • Building 2

    Quality control inspections are currently underway, indicating that construction and interior finishing work have been completed. This stage ensures that all work meets required standards and specifications. Any final deficiencies identified will be addressed before the building moves toward final readiness.

    Building 3

    Excavation is in progress, marking the very early stage of construction. This work prepares the site for foundation installation. Once excavation is complete, footing and foundation construction will follow.

    Building 7

    Back framing and window installation are underway, bringing the building closer to full enclosure. Completing this work helps protect the interior from weather and allows mechanical and electrical rough-ins to proceed. This marks a key transition toward interior construction.

    Building 12

    Painting and flooring are currently in progress, signaling that drywall, taping, and ceiling finishes have been completed. These finishes significantly advance the interior toward completion. Once finished, the building will move into final trim and fixture installation.

    Building 13

    Electrical and HVAC rough-ins are underway, establishing essential systems within the building before walls are closed in. This stage ensures all services are properly placed and inspected. Following rough-ins, the project will progress to insulation and drywall installation.

  • Building 2

    Painting and flooring are currently underway, indicating that drywall, taping, and priming have been completed. This stage brings the interior closer to its finished appearance. Once flooring is complete, the building will move into final trim work and fixture installation.

    Building 7

    Framing is in progress, marking the transition from foundation work to vertical construction. This stage establishes the building’s structure, including walls, floors, and the overall layout. Once framing is complete, roofing and exterior sheathing will follow to enclose the building.

    Building 11

    A final quality check is underway, confirming that all major construction and finishing work has been completed. This step ensures that the building meets all standards and specifications before turnover tasks begin. Any minor adjustments or touch-ups identified during the check will be addressed promptly.

    Building 12

    Ceiling texture application is in progress, following the completion of drywall installation and taping. This stage prepares the ceilings for final paint and interior finishing. Once texture work is complete, painting and trim installation will begin.

    Building 13

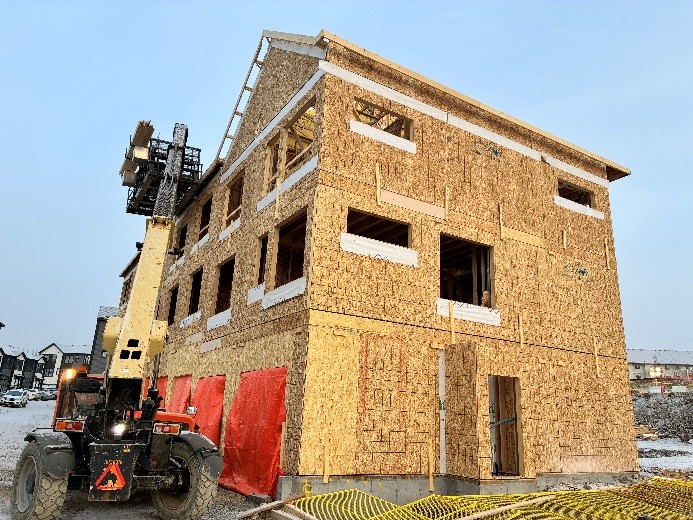

    Roof installation and back framing are underway, moving the building toward full enclosure. Completing the roof protects the structure from weather and allows interior mechanical and electrical work to begin. Back framing ensures all remaining structural elements are completed before transitioning to rough-ins.

  • Building 2

    Taping is beginning this week, which marks an important step in finishing the interior drywall. This stage smooths and prepares the walls for painting and trim work. Once taping is complete, the building will progress into the final interior finishing phases.

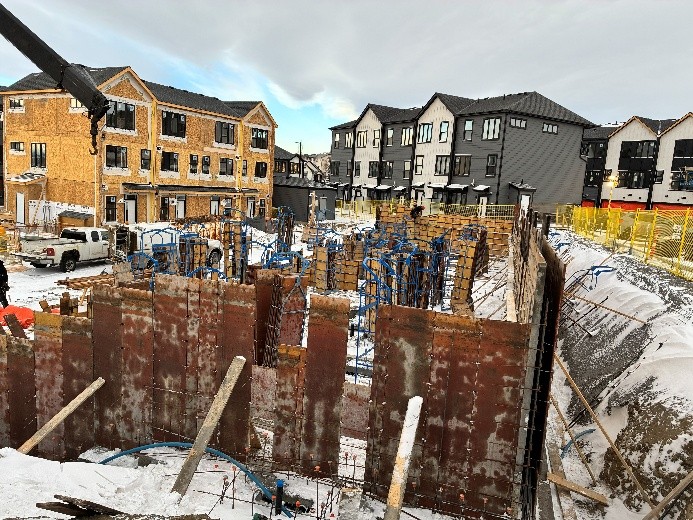

    Building 7

    The team is currently forming the foundation walls, a key step in establishing the structural base of the building. Once these walls are cured and backfilled, framing will begin. This transition marks the shift from groundwork to vertical construction.

    Building 11

    Flooring installation is underway, indicating that earlier interior stages—such as drywall, painting, and base mechanical work—have been completed. Flooring is one of the final interior milestones before cabinetry, trim, and final fixtures are installed. This moves the building into the late stages of interior finishing.

    Building 12

    Electrical rough-ins are currently in progress, ensuring that wiring and electrical pathways are properly placed before walls are closed in. Once rough-ins are completed and inspected, the next steps will move toward insulation and drywall. This stage is critical for preparing the building for interior enclosure.

    Building 13

    Framing of the second-floor walls is ongoing, meaning the building’s structure is actively taking shape. Once framing is complete, roof trusses and sheathing will follow, enclosing the building. After enclosure, the project will transition into mechanical, electrical, and plumbing rough-ins.

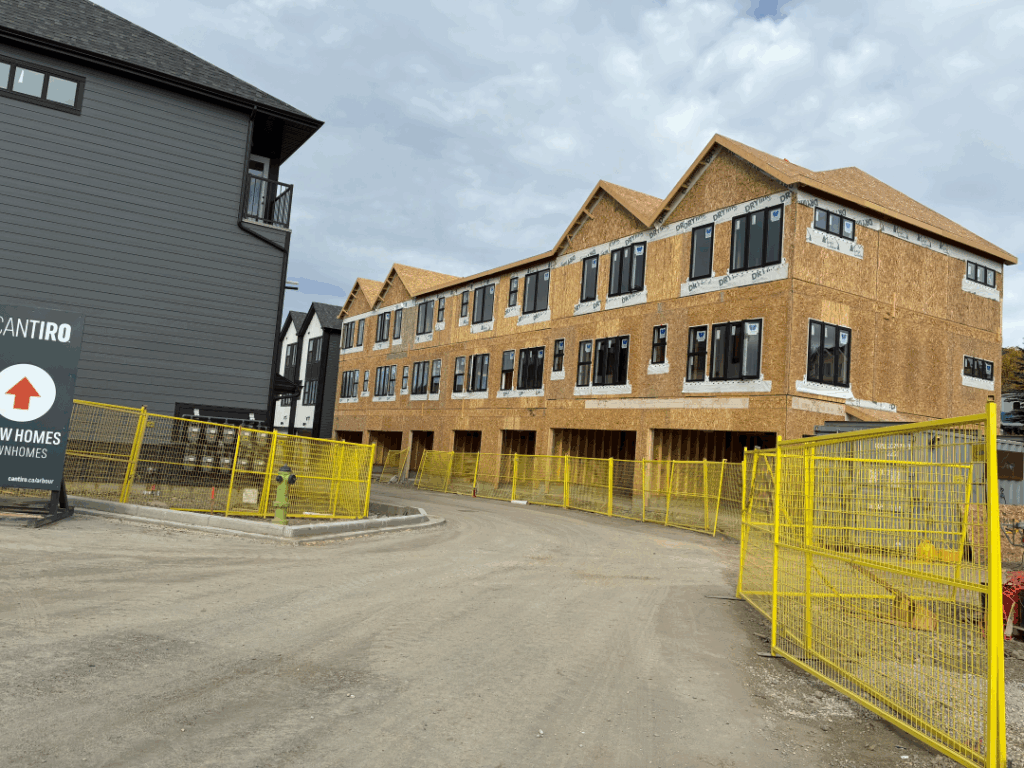

  • Building 2

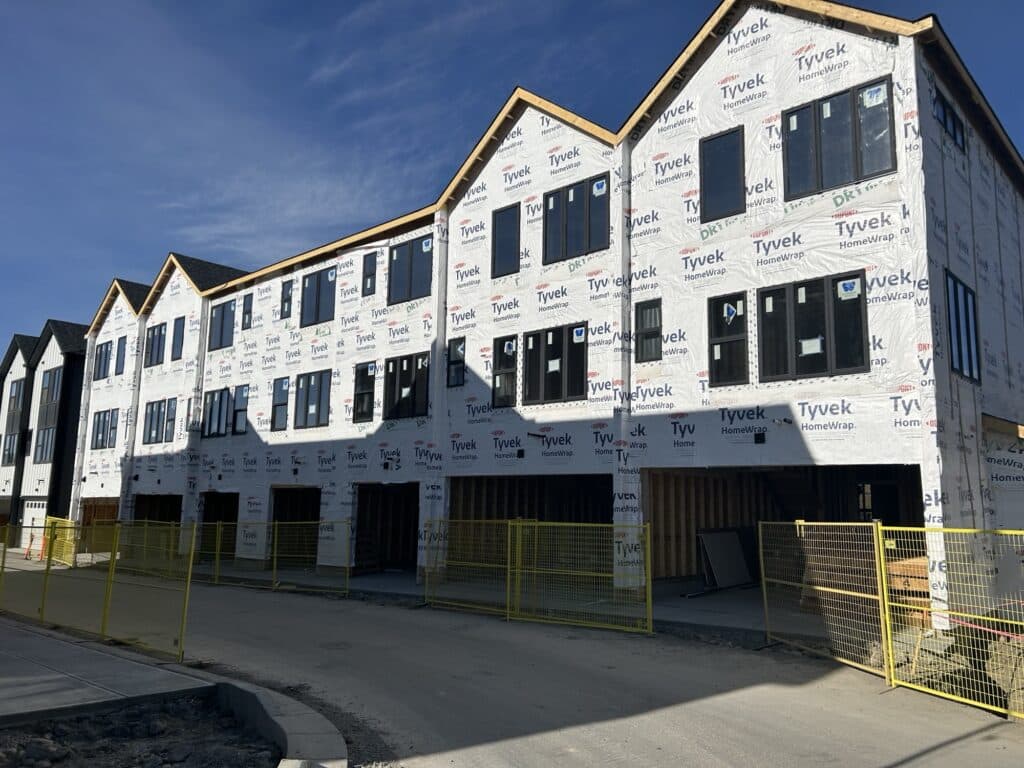

    Exterior finishing is currently ongoing, and rough-ins are in progress. These steps mark continued advancement toward the building’s completion.

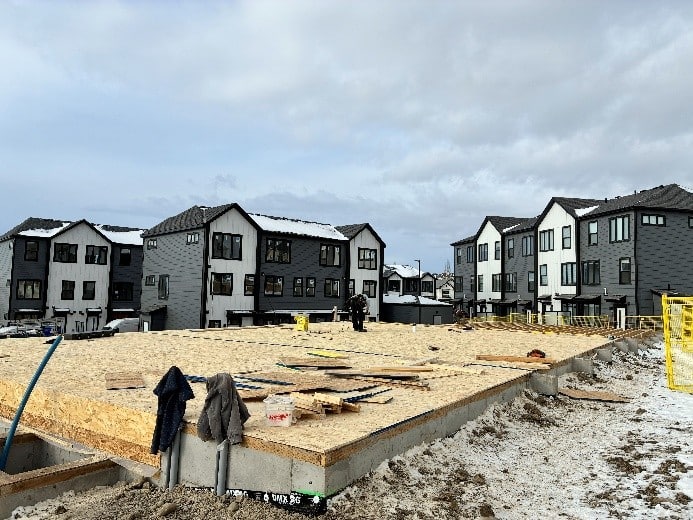

    Building 7

    Excavation is ongoing, preparing the site for foundation work and the next phase of construction.

    Building 11

    The building is in the interior finishing stage, with work focused on completing final details and preparing for inspections.

    Building 12

    Framing has been completed, and rough-ins are currently underway. This progress moves the building closer to the drywall and finishing phases.

    Building 13

    Foundations have been completed, providing a solid base for the structure and setting the stage for framing to begin.

  • Building 2

    Electrical rough-ins are currently underway, marking progress in the installation of essential systems.

    Building 7

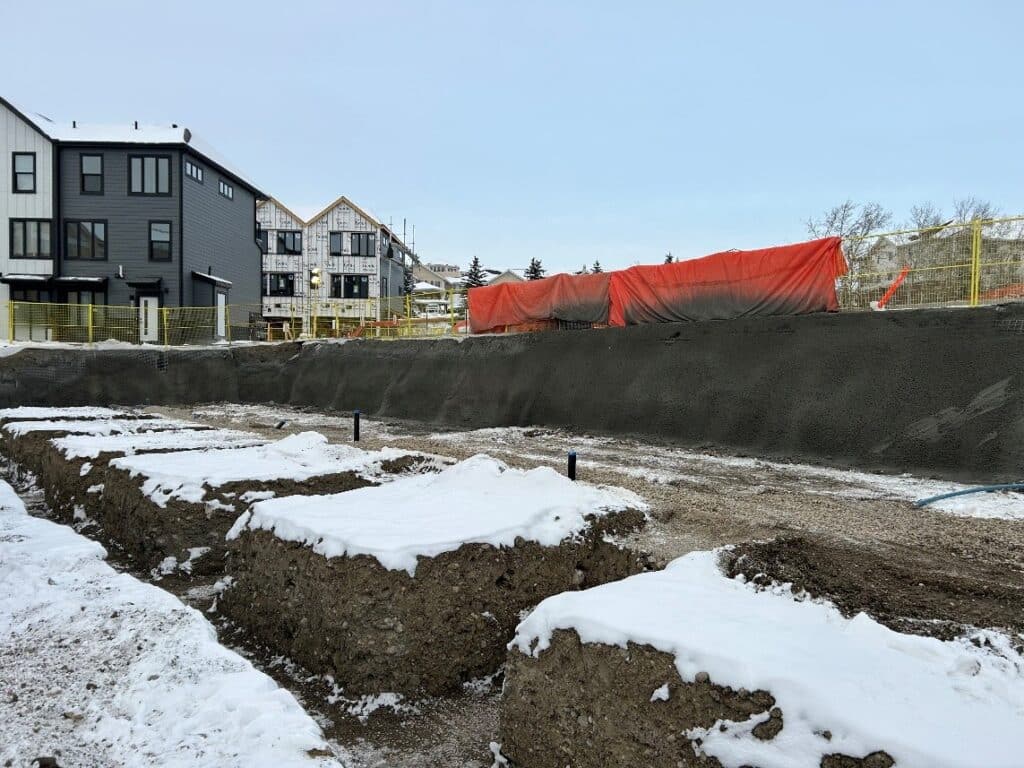

    Excavation is in progress, preparing the site for foundation work.

    Building 8

    Occupancies are underway, indicating the building is complete and residents are beginning to move in.

    Building 9

    Final inspections have been completed in the upper units, while flooring installation is underway in the lower units.

    Building 10

    Final inspections have been completed in the upper units, and flooring installation is in progress in the lower units.

    Building 11

    Drywall installation is currently underway, moving the building further into the interior finishing phase.

    Building 12

    Framing is complete, with rough-ins expected to be completed by the end of next week.

    Building 13

    Footing installation is scheduled to begin tomorrow, marking the start of foundation work.

  • Building 2

    Building 2 has completed its framing stage, as planned. Roofing work has now begun, marking a significant step forward in the construction process.

    Building 8

    Building 8 has completed final inspections and quality assurance checks. These steps confirm that the building meets required standards and is ready for occupancy. The project continues to move steadily toward completion.

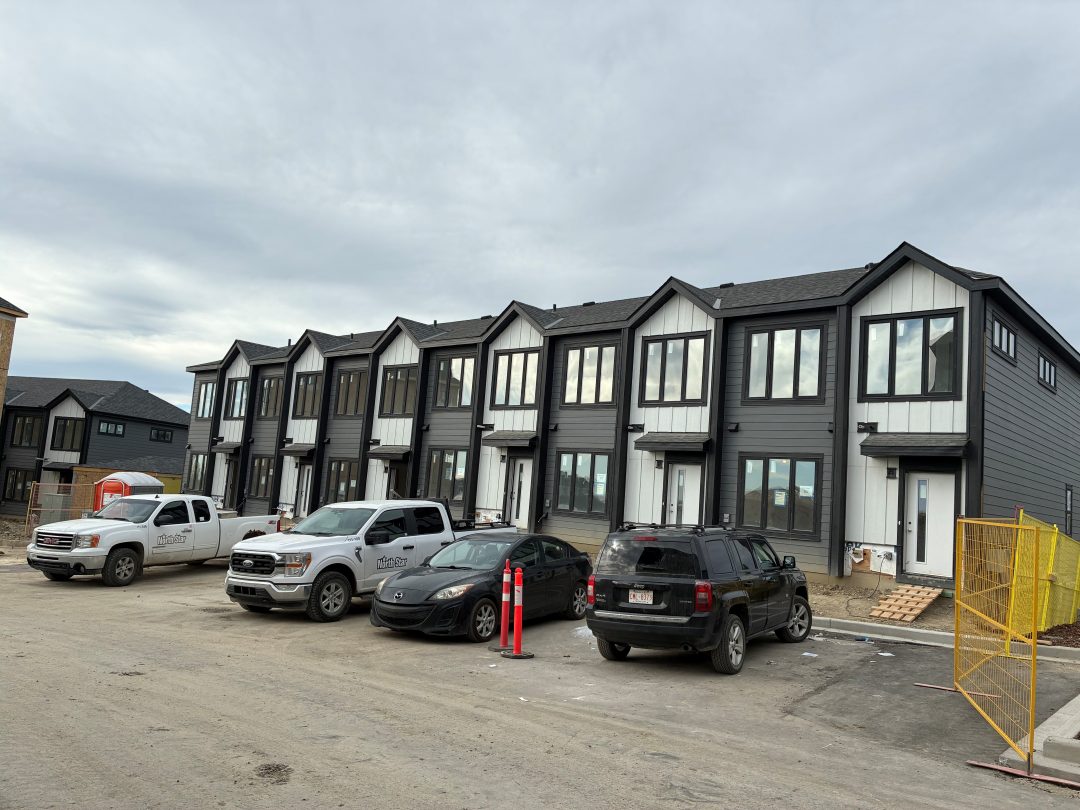

    Building 9

    Building 9 has completed drywall installation in the lower units. Cabinet installation has been completed in the upper units. These finishes mark continued progress toward preparing the building for final stages.

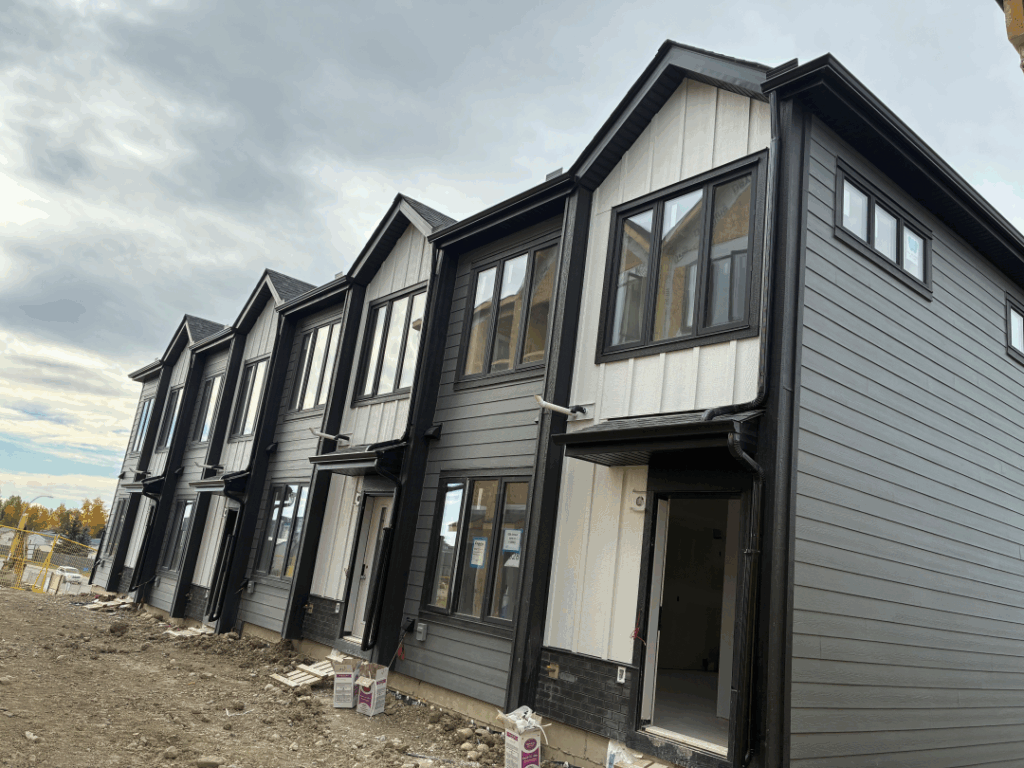

    Building 10

    Building 10 has completed bulkhead installation in the lower units. Drywall installation has been completed in the upper units. These interior finishes mark continued progress toward preparing the building for final detailing and inspections.

    Building 11

    Building 11 has completed electrical, mechanical, and plumbing rough-ins. Exterior cladding installation is also complete. These milestones mark steady progress toward enclosing the building and preparing for interior finishes.

    Building 12

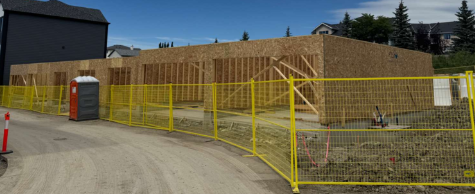

    Building 12 has begun framing, marking the start of vertical construction. This follows the completion of foundation walls and backfilling. The project is now progressing into the structural phase.

  • Building 1

    Building 1 has reached an exciting milestone with the successful soft opening of our show homes, and we’re now preparing for the grand opening on September 13th . Final inspections are underway, and we are on track to begin occupancies and possessions starting in September and continuing into early October. This marks a major step forward for the project as we get ready to welcome our first homeowners.

    Building 2

    Construction on Building 2 is progressing as planned. The framing stage is in progress and is scheduled for completion by the end of September, to be followed by roofing.

    This progress marks an important step toward preparing the building for subsequent construction phases.

    Building 8

    Building 8 has completed installation of drywall and is currently in the finishing stage, with paint touch-ups in progress and millwork installation being completed.

    This brings the building closer to completion and readiness for final inspections.

    Building 9

    Building 9 is progressing steadily, with upper units currently in the drywall and taping stage, followed by upcoming inspections.

    Basement units have completed IPDs and are scheduled for HVAC and gas installations, marking key steps toward overall project completion.

    Building 10

    Building 10 has completed all major structural and envelope work, with electrical and mechanical rough ins also finalized followed by building interior insulation.

    Interior drywall installation is set to commence, moving the building into its next phase of construction.

    Building 11

    Building 11 has completed framing up to the roof level, with inspections to follow. Window installation is also finished, and interior walls and stairs are currently in progress. The building is now ready to advance to the next stage, beginning with electrical, mechanical, and plumbing rough-ins.

    Building 12

    Building 12 has completed foundation walls and backfilling and is now prepared for the next phase of construction with the slab-on-grade installation.

  • Building 1

    Building 1 has reached a major milestone with all key interior and exterior work now complete. Landscaping is scheduled to begin this month. Final inspections and occupancy preparations are underway, signaling the final phase before handover.

    Building 2

    The foundation has been completed, marking a solid step forward in construction. The site is now ready for structural framing to begin. Progress remains on track with the overall project schedule.

    Building 8

    Exterior cladding is complete, and all mechanical and electrical rough-ins have been finalized. Interior walls have been insulated and caulked. Drywall installation is ready to begin.

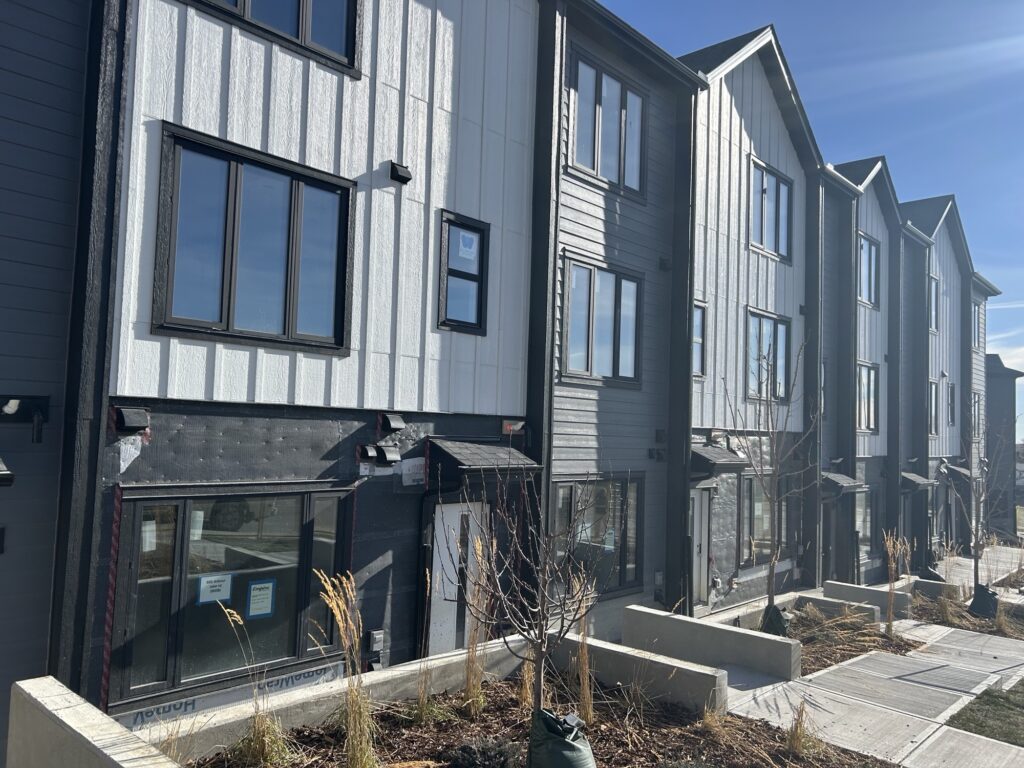

    Building 9

    Major exterior work, including the west-side retaining wall, is complete. Rough-ins are nearly finished. Drywall installation is scheduled for late August.

    Building 10

    Rough-ins are nearing completion, followed by insulation and caulking of interior walls. Drywall work is set to begin in late August. The concrete foundation for the enclosed bike storage between Buildings 9 and 10 has been poured.

    Building 11

    The foundation is fully complete, and framing is currently underway. This marks the start of the building’s structural development. Next steps include roof structure, exterior sheathing, mechanical rough-ins, cladding, and interior wall prep.

    Building 12

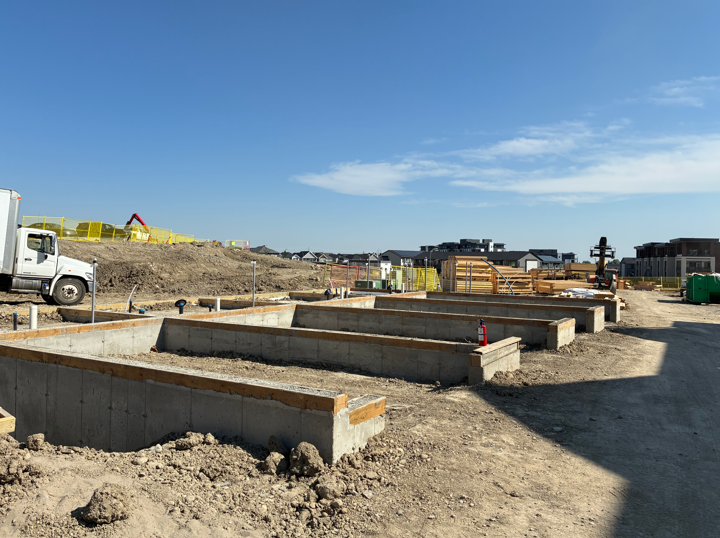

    Excavation has been completed in preparation for foundation work. Footing formwork and rebar placement are expected to begin shortly. This sets the stage for the building’s structural base.

  • Building 1

    We’ve entered the finishing stages of construction. Work on the exterior retaining wall is currently underway. Concrete and landscaping are scheduled to begin in July.

    Building 2

    The foundation has been completed. This provides a solid base for the structure. The building is ready for the next phase of construction.

    Building 8

    Rough-ins are nearly complete. Drywall installation is set to begin in July. Concrete and landscaping work will also start in July.

    Building 9

    Rough-in work is wrapping up. Drywall is scheduled to begin in July. Concrete and landscaping are also planned for July.

    Building 10

    Rough-ins are nearing completion. Drywall installation is expected to start in July. The building is progressing steadily toward interior work.

    Building 11

    The foundation is complete. Framing is scheduled to begin in July. This will mark the start of the building’s vertical construction.

  • Building 1

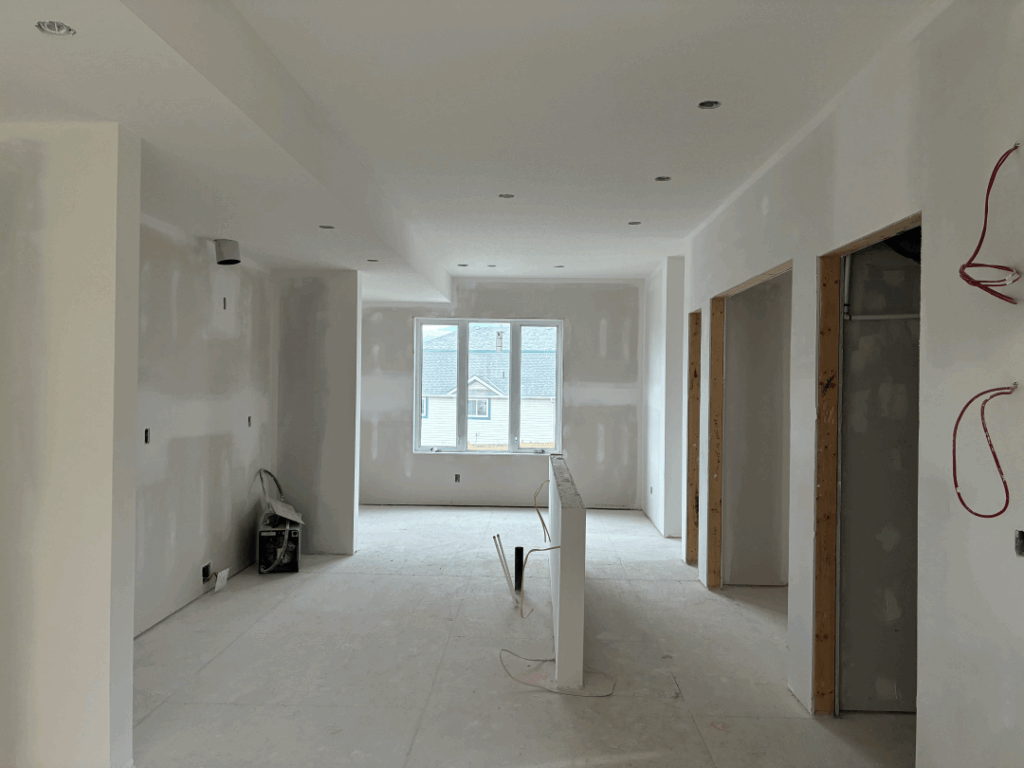

    Drywall installation has been completed. The interior finishes are now underway. This phase includes details like painting, flooring, and trim work to complete the interior spaces.

    Building 2

    Foundation work is currently underway. Crews are actively constructing the structural base of the building. This stage is essential for supporting the rest of the construction.

    Building 8

    Mechanical rough-ins are currently underway. This includes the installation of HVAC systems and other mechanical components. It’s a key step in preparing the building for interior finishes.

    Building 9

    Mechanical rough-ins are currently underway. This includes the installation of HVAC systems and other mechanical infrastructure. It’s a critical step before moving on to insulation and drywall.

    Building 10

    Mechanical rough-ins are in progress. HVAC systems and mechanical components are being installed efficiently. This progress positions the building closer to the insulation and drywall phase.

    Building 11

    The foundation has been completed. This marks a major milestone in the early stages of construction. The building is now ready for framing to begin.

  • Building 1

    The siding installation is finished. Drywall work is currently in progress. This phase involves creating the interior walls.

    Building 2

    Excavation is complete. Foundation work is underway. The building’s structural base is being constructed.

    Building 8

    The framing is complete. Rough-in work has started. Essential systems like plumbing and electrical are being installed.

    Building 9

    The framing is done. Roofing work is underway. Workers are placing the roofing materials to cover the building.

    Building 10

    The siding is fully installed. Rough-in work is in progress. This includes installing the building’s essential systems.

    Building 11

    Excavation is ongoing. The foundation work has started. This phase involves laying the building’s structural base.

  • Building 1

    The siding work has just started. Workers are preparing the exterior for the new siding. This marks the beginning of the building’s exterior transformation.

    Building 8

    The roof shingle installation is now complete. The building’s roof is fully covered and protected. This milestone ensures the building is weatherproof.

    Building 9

    The roof installation is currently in progress. Workers are actively placing the roofing materials. Soon, the building will have a fully installed roof.

    Building 10

    The rough-in phase has commenced. This involves installing the essential systems like plumbing and electrical. It’s a crucial step before the interior finishes can begin.

  • Building 10

    Roofing has begun! The crew is hard at work, and we’re thrilled to see this stage in action.

    Building 9

    We are in the prefabrication phase, and things are moving along smoothly. The pieces are being carefully prepared for assembly, setting the stage for a seamless build process. This phase is key to keeping the momentum going, and we’re excited to see what’s next!

    Building 8

    We’re making great strides! The second floor framing is officially underway, and it’s looking fantastic. The structure is coming to life, and we can already imagine how this space will come together as we move upwards!

    Building 1

    We’re thrilled to see things taking shape and can’t wait to see it fully covered and ready for the next steps

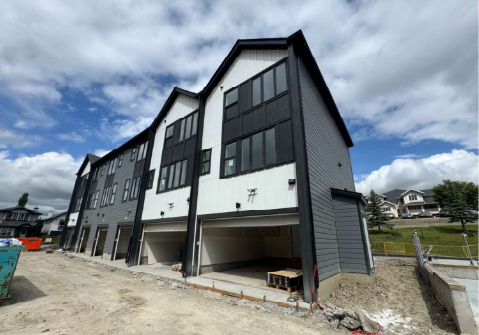

    Building 1

    Exciting news! The roofing has officially started. This is a major milestone as the building moves closer to completion.

  • Building 1

    The foundation for Building 1 is complete, inspections have passed, and backfilling is now underway! Things are moving forward smoothly.

    Building 8

    The foundation wall pour for Building 8 is now underway. Progress is moving forward as scheduled.

    Building 9

    The foundation for Building 9 is complete, inspections have passed, and backfilling is now in progress! We’re making great strides!

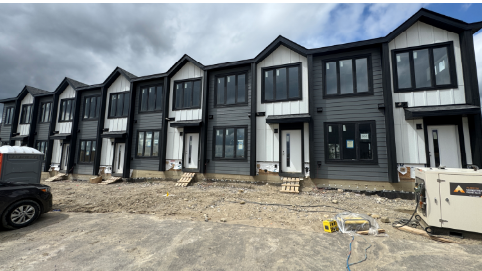

    Building 10

    Building 10 is progressing well— the foundation is complete, inspections have been passed, and backfilling is now underway. Things are moving along as planned.

  • Building 1

    The concrete for Building 1 has been successfully poured, marking an exciting milestone in its construction. This critical step ensures a strong and stable foundation for everything to come. We’re thrilled to see this project taking shape, one step closer to completion!

    Building 9

    Building 9 has reached a major milestone with the concrete foundation now in place. This foundational work is essential to creating a durable and long-lasting structure. With this step completed, we’re eager to move forward with the next stages of construction.

    Building 10

    Concrete has been poured for Building 10, solidifying its foundation and setting the stage for future progress. A strong foundation is key to any successful build, and we’re proud to achieve this milestone. Stay tuned as we continue bringing Building 10 to life!

  • Project

    • Site Paving: The paving on site has been completed.

    Building 1, 8, 9, 10

    • Foundations: Digging has begun for the foundations on building 1, 8, 9, and 10.
    • Excavation: Buildings 1, 9, and 10 fully excavated with building 8 half way complete

    Building 1, 10

    • Form Work: Form work for footings installed and inspections passed for buildings 1 and 10.

    Project

    • Development Permit: We are excited to announce our development permit was released on November 28.
    • Project Touchpoint: Sales Manager (Leah Turner) will be reaching out to book a meeting with purchasers to share electrical layouts and answer any questions.

  • Project

    • Development Permit: We are pleased to announce that the Development Permit was approved with conditions on October 8, 2024. If you would like more information about this process, please visit here.
    • Site Servicing: The site servicing is now complete, marking a significant step forward in our development process.
    • Excavation: Excavation work is set to commence in November, bringing us closer to the construction of your new townhome.
